Transmission Network Planning
Tx Survey:
An LOS (Line of Sight) survey is conducted on the final survey site to verify the M/W connectivity to the planned site.
LOS survey is carried out in the following steps:
- Collect Nominals of proposed site and those of the nearest locations to which customer proposes the LOS connectivity & Verification.
- Record latitude, longitude, building data, obstruction data and surrounding terrain data on the LOS Survey template

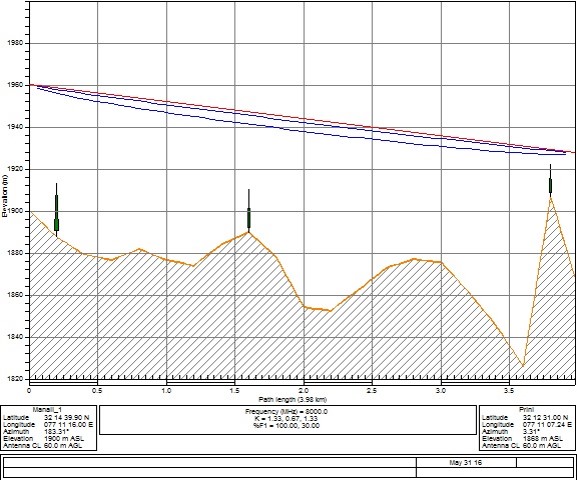

- Generate LOS Path Profile for the proposed Link using Pathloss 4.0
- Generate LOS report for the proposed Link using Pathloss 4.0.Conduct physical survey of the hop to identify any field obstructions and verify the LOS path profile.
Frequency Planning:
Use minimum frequency from frequency list to prepare effective network with no interference.
Capacity Planning: Optimisation of a Cellular system is a cyclic and repititive process, which involves theoritical network design and thereafter tuning of network parameters by means of physical onsite measurements.
